[project_hero]

Richmond Valley Council Project Case Study

The Richmond Valley Pump Station project represents a highly specialised renewable energy deployment, integrating solar PV infrastructure within a flood-prone operational environment. Delivered for Richmond Valley Council, the project required a design-led approach that balanced energy generation, structural resilience, and uninterrupted critical water infrastructure operations.

Richmond Valley Council Project Case Study

The Richmond Valley Pump Station project represents a highly specialised renewable energy deployment, integrating solar PV infrastructure within a flood-prone operational environment. Delivered for Richmond Valley Council, the project required a design-led approach that balanced energy generation, structural resilience, and uninterrupted critical water infrastructure operations.

Project Overview

The Richmond Valley Pump Station project represents a highly specialised renewable energy deployment, integrating solar PV infrastructure within a flood-prone operational environment. Delivered for Richmond Valley Council, the project required a design-led approach that balanced energy generation, structural resilience, and uninterrupted critical water infrastructure operations.

At its core, the project involved the installation of a ground-mounted solar PV system engineered specifically for flood immunity. Unlike conventional ground mount arrays, the system was elevated approximately four metres above ground level to mitigate flood risk, ensuring asset protection and operational continuity during extreme weather events common to the Richmond Valley region.

From an engineering standpoint, the project demanded close integration between civil, structural, and electrical disciplines. The elevated mounting structure was designed in accordance with AS 1170, accounting for wind loading, hydrodynamic forces, and debris impact during flood events. Geotechnical considerations also played a critical role, with footing design tailored to local soil conditions and floodplain behaviour.

Electrically, the system was configured to seamlessly interface with the pump station’s existing load profile, supporting daytime energy offset while maintaining reliability for essential services. Given the critical nature of the asset, system design prioritised robustness, maintainability, and safe access, with all components selected to withstand harsh environmental conditions.

A key challenge on the project was constructability within a live operational site. Works were carefully staged to avoid disruption to pump station functionality, with strict safety controls implemented around access, lifting operations, and working at heights. The elevated structure introduced additional complexity in installation sequencing, requiring detailed planning and coordination across all delivery teams.
This project demonstrates TSP Energy’s capability to deliver technically complex renewable solutions in constrained and high-risk environments. It highlights a broader expertise in designing for resilience, particularly in regional and infrastructure-critical applications where standard solar approaches are insufficient.

From a lifecycle perspective, the Richmond Valley Pump Station aligns with a long-term asset strategy – designed not only for immediate performance but for durability, maintainability, and adaptability in the face of changing environmental conditions.

What led Richmond Valley Council to initiate this project?

The initiation of the Richmond Valley Pump Station solar project by Richmond Valley Council was driven by a combination of operational, financial, and strategic factors typical of critical infrastructure owners, however with a strong emphasis on resilience and whole-of-life value rather than just simple energy savings.

1. Energy Cost Reduction for High-Load Infrastructure

Pump stations are inherently energy-intensive, operating large motors over extended periods. The council was seeking to materially reduce ongoing electricity expenditure, particularly during daytime peak tariff periods. Solar PV provided a direct offset to this load, improving operating cost predictability and reducing exposure to volatile electricity pricing.

2. Protection of Critical Services (Resilience-First Mindset)

Unlike typical commercial solar projects, this was not purely a financial play. The pump station is a critical water infrastructure asset, meaning reliability is non-negotiable. The customer was looking for a solution that could coexist with flood risk and continue delivering value without introducing operational vulnerability.

This is what led to the specialised engineering requirement – an elevated solar structure capable of withstanding flood events while maintaining system integrity.

3. Climate and Environmental Risk Response

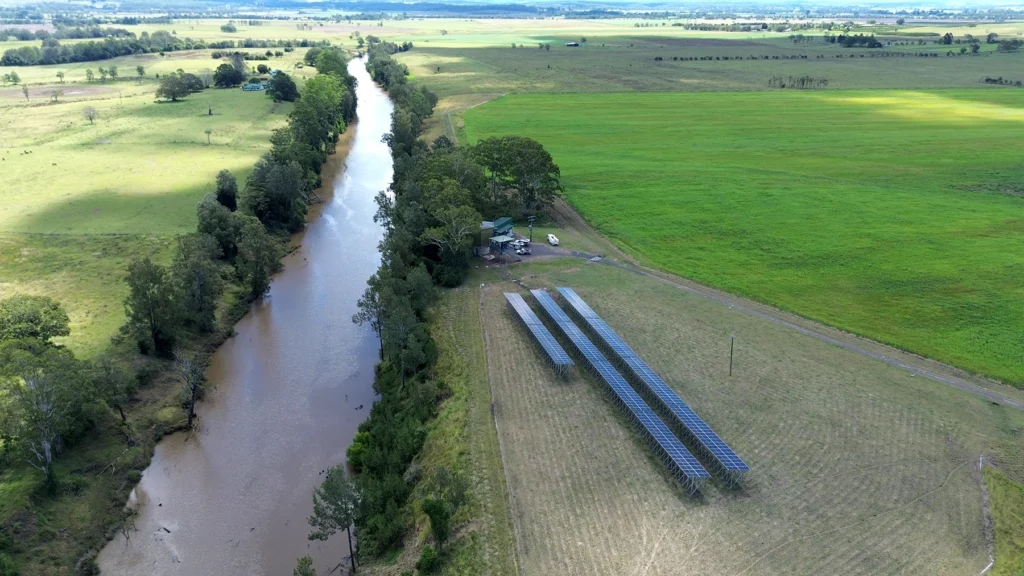

The Richmond Valley region has experienced significant flooding events. The council was proactively looking to future-proof infrastructure against climate-related risks. This project forms part of a broader strategy to ensure assets are not only decarbonised but also physically resilient to environmental extremes

4. ESG and Sustainability Objectives (Scope 2 Emissions Reduction)

As a local government body, Richmond Valley Council has increasing accountability around sustainability and emissions reporting.
The project contributes directly to:

Reduction in Scope 2 emissions (grid electricity consumption)
Alignment with council-level climate action plans
Demonstrable leadership in renewable adoption within regional NSW

5. Long-Term Asset Strategy and Lifecycle Thinking

The customer was not looking for a lowest-cost installation. They were seeking a solution that:

Integrates with existing infrastructure
Minimises maintenance complexity
Survives extreme conditions
Delivers consistent performance over decades

This aligns strongly with a lifecycle-driven procurement mindset, where upfront investment is justified by long-term reliability and reduced intervention costs.

6. Regional Leadership and Demonstration Effect

There is also a reputational and strategic layer. Regional councils are increasingly expected to lead by example in sustainability and infrastructure innovation. This project positions Richmond Valley Council as a forward-thinking authority capable of delivering non-standard, high-performance renewable solutions in challenging environments.

Challenges & Solutions

This project presented a set of non-standard challenges driven by the site’s flood exposure, critical infrastructure status, and integration constraints. The value delivered by TSP Energy was not just in installing solar, but in solving these engineering and operational problems in a structured, risk-managed way.

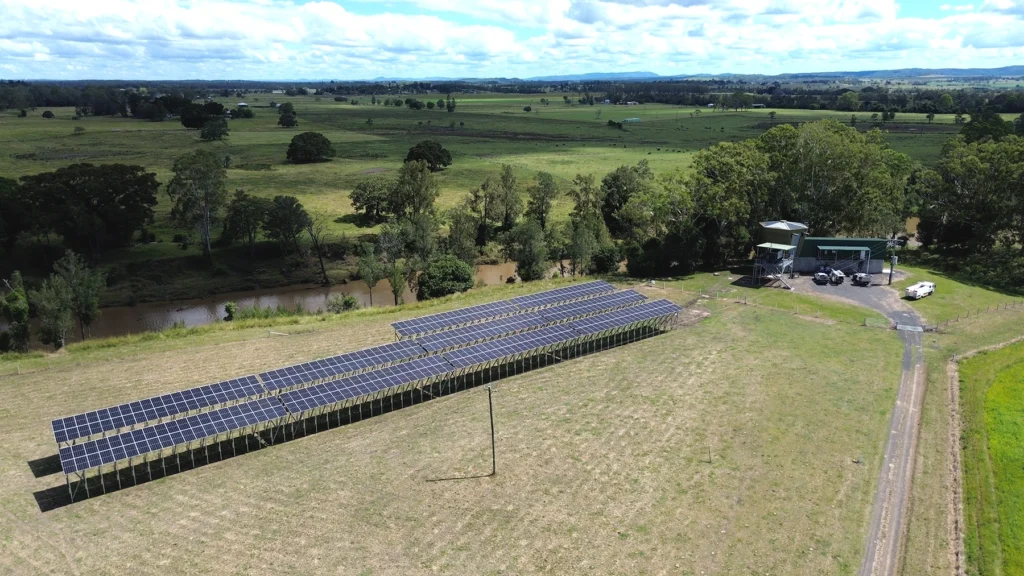

Flood-Prone Site Conditions

Challenge:

The pump station is located in a known floodplain with a history of significant inundation. A conventional ground mount system would be at high risk of damage, debris impact, and complete loss during flood events.

TSP solution:

Engineered a 4 metre elevated solar structure to sit above historical and modelled flood levels
Structural design accounted for hydrodynamic loads, debris impact forces, and wind loading in accordance with AS 1170
Designed robust footing systems based on geotechnical conditions to prevent scour and instability

Outcome:

A flood-resilient solar asset that maintains integrity and avoids costly replacement or downtime after major weather events.

Maintaining Continuous Operation of Critical Infrastructure

Challenge:

The pump station is an essential service asset. Any interruption to operations during construction or integration posed unacceptable risk to water infrastructure.

TSP solution:

Developed a staged construction methodology to isolate works from live operations
Developed a staged construction methodology to isolate works from live operations
Close coordination with Richmond Valley Council operational teams

Outcome:

Zero impact to critical operations during delivery, with seamless commissioning into the existing system.

Complex Structural and Civil Integration

Challenge:

Elevating a large solar array introduces significant structural complexity, including load transfer, stability, and constructability at height.

TSP solution:

Delivered a fully integrated civil, structural, and electrical design
Custom steel structure designed for high durability in corrosive and wet environments and safe maintenance access at height
Sequenced installation to safely erect elevated frames using controlled lifting strategies

Outcome:

A structurally sound, maintainable system that meets both engineering and operational requirements.

Constructability and Safety Constraints

Challenge:

Working at height, in a regional environment, on an operational asset introduced elevated safety risks and logistical challenges.

TSP solution:

Implemented stringent WHS controls including working at heights systems, lift planning, and exclusion zones
Leveraged regional delivery capability to mobilise efficiently and reduce reliance on external metro-based resources

Outcome:

Safe project delivery with no compromise to workforce or site safety standards.

Electrical Integration with Existing Load Profile

Challenge:

The system needed to integrate with an existing high-demand pump load without introducing instability or inefficiencies.

TSP solution:

Designed the PV system to align with daytime load demand, maximising self-consumption
Ensured compatibility with existing switchboards and protection systems
Prioritised system robustness over aggressive export strategies

Outcome:

Optimised energy offset with stable and reliable system performance.

Designing for Long-Term Maintenance in a Harsh Environment

Challenge:

Flood-prone, regional sites are difficult and costly to maintain. Poor design would result in ongoing operational inefficiencies.

TSP solution:

Incorporated safe access provisions for inspection and cleaning
Selected durable materials suited to wet and corrosive environments
Designed with a lifecycle focus rather than a short-term installation mindset

Outcome:

Reduced long-term maintenance burden and improved asset longevity.

Project Delivery & Management

The delivery of the Richmond Valley Pump Station project required a highly controlled approach due to the combination of regional logistics, elevated construction, and live infrastructure constraints. The challenges were not limited to engineering design, but extended across procurement, sequencing, safety, and stakeholder coordination.

Regional logistics and mobilisation

Challenge:

The site is located in a regional area with limited access to specialised equipment, skilled labour, and just-in-time delivery options. Transporting large structural components and coordinating trades introduced programme risk.

TSP solution:

Early procurement and staging of critical materials to avoid delays
Use of a regional delivery model with established subcontractor networks
Consolidated deliveries and planned laydown areas to minimise site congestion

Outcome:

Improved programme certainty and reduced exposure to supply chain disruptions.

Constructing an elevated structure

Challenge:

Installation of a 4 metre elevated solar structure introduced significant complexity in lifting, sequencing, and working at heights.

TSP solution:

Installation of a 4 metre elevated solar structure introduced significant complexity in lifting, sequencing, and working at heights.
Sequenced erection methodology to maintain stability during construction
Strict working at heights procedures and certified access systems

Outcome:

Safe and efficient installation of a non-standard structure without incident.

Working within a live operational site

Challenge:

The pump station remained operational throughout the project. Any disruption to electrical or mechanical systems posed a risk to essential services.

TSP solution:

Close coordination with Richmond Valley Council and site operators
Defined exclusion zones and permit-to-work systems
Planned tie-in works during controlled windows with contingency measures

Outcome:

No disruption to pump station operations during construction or commissioning.

Integration with existing electrical infrastructure

Challenge:

Connecting new solar generation into an existing switchboard and load profile required careful planning to avoid faults, downtime, or compliance issues.

TSP solution:

Pre-construction verification of existing infrastructure and protection systems
Controlled commissioning process with staged energisation
Compliance with relevant standards and network requirements

Outcome:

Seamless integration with stable system performance from day one.

Safety management in a high-risk environment

Challenge:

The project combined multiple high-risk activities including working at heights, crane lifts, and live electrical works.

TSP solution:

Implementation of comprehensive WHS management plans
Implementation of comprehensive WHS management plans
Regular site audits and toolbox talks to maintain safety discipline

Outcome:

Strong safety performance with no compromise to personnel or site operations.

Programme and weather constraints

Challenge:

Flood-prone conditions and weather variability created uncertainty in scheduling and site access.

TSP solution:

Built float into the construction programme for weather-related delays
Prioritised critical path activities during favourable conditions
Designed temporary works and access planning to suit site conditions

Outcome:

Designed temporary works and access planning to suit site conditions

Coordination across multiple disciplines

Challenge:

The project required tight coordination between civil, structural, and electrical teams, all working within a constrained and active site.

TSP solution:

Centralised project management through TSP’s internal team
Clear communication protocols and sequencing plans
Alignment of design and construction teams from early stages

Outcome:

Efficient delivery with minimal rework and strong alignment across all disciplines.

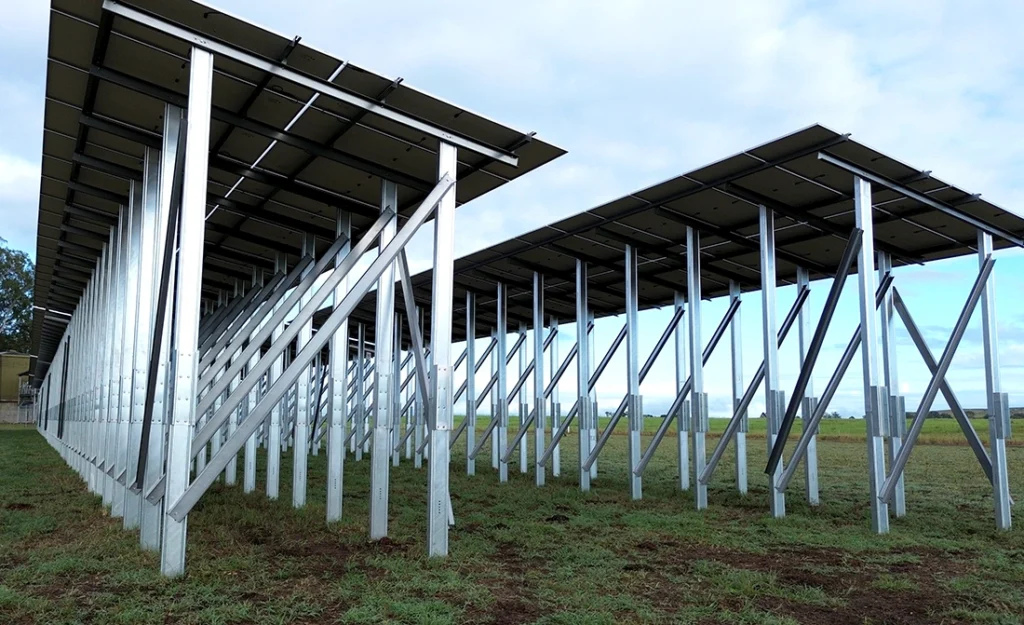

4 m high ground mount

Able to withstand cows grazing underneath

Able to withstand flood conditions

Rebates Secured

STC’s

LGC’s

250 kW
Casino, NSW
413.72 MWh Annually
Government, Agriculture
February 2026
Government, Ground Mount Solar
  • Government Ground Mount Solar
  • Government Solar
